Most industrial companies treat time-to-market as an engineering problem. They hire more engineers. They run agile workshops. They restructure phase gates. The development cycle still takes 36 months.
A typical product development process spans strategy, R&D, regulatory, supply chain, and commercial functions. Each function moves at a reasonable pace inside its own walls. The months disappear between them. They sit in approval queues, waiting for market research, in supplier qualification cycles, in portfolio reviews tied to the fiscal calendar instead of the development phases.
If your development team finishes its work in 18 months but the product reaches the market in 36, you have a coordination problem.
This article makes the case that the highest-leverage time-to-market improvement in industrial companies is a shorter wait time between phases. A 6-step framework shows how, illustrated with real cases from Boeing, Toyota, and Tesla.
Why time-to-market is a coordination problem, not a development speed problem
Time-to-market refers to the elapsed time from product concept approval to first customer shipment. In industrial sectors, this number ranges from 18 months to over 8 years. There is considerable variation across different industries and even between competitors in the same segment.
The variation rarely tracks with engineering capacity.
-
Companies with larger development teams do not consistently launch faster.
-
Companies running agile practices do not consistently launch faster either.
In most industrial development cycles, engineering work absorbs roughly 40-55% of the entire process. The remaining 45-60% is coordination overhead: Gate approvals, regulatory reviews, supplier qualifications, portfolio decisions, stakeholder sign-offs, and market research handoffs.
The math is unforgiving.
-
Cutting engineering work by 30% reduces total time-to-market by 12-16%.
-
Cutting coordination wait time by 30% reduces it by 15-20%.
The same effort applied to coordination yields a larger return.
This explains why "we need more agile" rarely fixes time-to-market in industrial settings. Agile-inspired methods speed up the development team, but they do not shorten the approval process, the regulatory review queue, or the supplier capacity lock.
How to measure time-to-market in industrial development
Most companies measure time poorly: They count from project kickoff to launch. This hides where the time actually goes.
Three measurements give an honest picture:
- Concept-to-shipment time. From product concept approval to first customer shipment. This is the formal definition of time-to-market.
- Engineering-active time. Total hours where development team members are actively progressing the work. Usually, 40-55% of the total.
- Wait time by phase. Time spent waiting between development phases for an approval, a decision, or input from another function.
Industry benchmarks help frame the gap. In consumer cell phones, total cycle time is typically 12-24 months. In automotive, 36-60 months for a new platform. In medical devices, 36-84 months. In commercial aerospace, 60-120 months.
Knowing the benchmark for your category is the starting point. Knowing the wait-time split is what makes the number actionable.
Three coordination failures that stretch the development process
Three failure patterns explain most coordination loss in industrial development.
Failure #1: Market research arrives after the design freeze
Market research often runs as a phase before development starts. The findings inform the product concept. Then the development team moves into design, and market signals stop flowing. By the time customer interviews surface as a real pain, the drawings are released, and supplier tooling is committed.
This pattern costs 4-12 months when late market feedback forces a redesign. The fix is to run market research as a continuous feed, not a gate.
Failure #2: The approval process is a queue, not a workflow
Industrial companies typically run 6-12 formal stage gates. Each gate is a meeting. Meetings get scheduled monthly or quarterly. A gate that should take a week of preparation can sit waiting 6-10 weeks for the next approval slot.
Multiply that across 8 gates, and you have 8-12 months of pure queue time. The fix is not faster meetings. It is pre-positioning the approval process so decision criteria are agreed upon before the gate.
Failure #3: Supply chain is downstream, not in the room
Long-lead components and supplier qualifications consume 6-18 months in many industrial categories. Most development processes engage suppliers after the design is locked. Lead times then stack on top of development time instead of running in parallel.
The fix is to engage key suppliers when concepts are sketched. Their constraints shape what is buildable before the development team commits to a first version.
A coordination-first product development strategy framework
The framework below is a 6-step product development strategy that fronts coordination work (Exhibit 1). Use it to redesign the entire process or to retrofit an existing product portfolio.

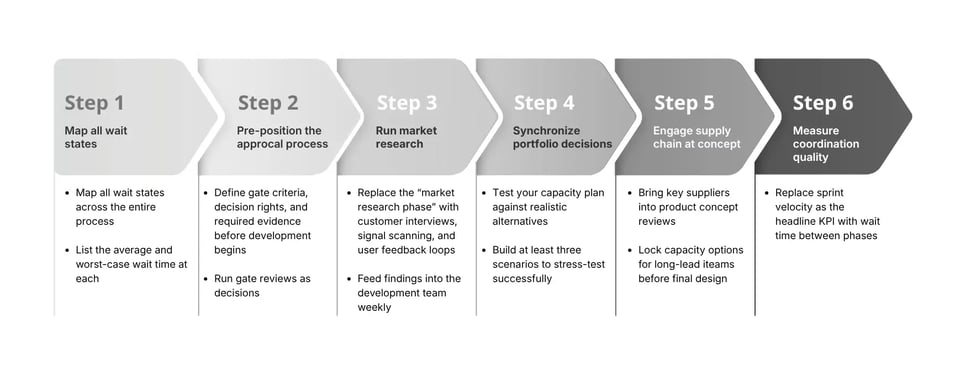

Exhibit 1: The coordination-first product development strategy framework
The framework attacks the 45-60% of cycle time that engineering practices cannot touch.
Real coordination wins and losses in industrial product development
The pattern shows up across industries. Three cases make it concrete: one of true coordination failure and two demonstrations of how coordination compresses time-to-market.
Boeing 787 Dreamliner: coordination failure adds 3+ years to product launch
Boeing outsourced about 70% of 787 production to more than 50 suppliers across multiple countries. The strategy was meant to cut costs, share risk, and accelerate development.
The first delivery was scheduled for May 2008. The actual first delivery happened in September 2011, more than three years later. Cost overruns ran into the billions.
The cause was a coordination breakdown: Fuselage barrels arrived in final assembly without wiring, brackets, or hydraulics installed. A shortage of fasteners forced Boeing to use temporary bolts bought from Home Depot to hold early aircraft together. Boeing eventually bought back struggling suppliers like Vought Aircraft Industries and Global Aeronautica to regain control.
Boeing executives later admitted "we outsourced too much" and began buying back struggling suppliers to regain oversight.
The lesson industry analysts drew was specific: outsourcing without integrated oversight collapses under complexity.
Toyota New Global Architecture: 20% fewer development resources through coordination
Toyota launched its New Global Architecture (TNGA) in 2015 with the fourth-generation Prius. The strategy standardised vehicle platforms and powertrain components across model lines and, critically, integrated suppliers "at a very early stage" of development.
Toyota reports a 20% reduction in development resources compared to its previous approach. Half of Toyota's global sales were on TNGA platforms by 2020.
Engineers worked on shared underbody, suspension, and powertrain components across multiple models concurrently. Suppliers participated in development phases earlier. Manufacturing lines were standardised so the same model could be built in multiple plants.
The savings were reinvested in product quality and new technologies, not used to ship the same products faster.
TNGA is the most documented case of a coordination-first product development strategy at scale in automotive.
Tesla and vertical integration: removing coordination boundaries
Tesla manufactures roughly 80% of components in-house, against an industry average of 20-30%. The choice is unusual, expensive, and operationally heavy. It is also a coordination strategy.
When the global semiconductor supply collapsed in 2021-2022, Tesla rewrote its vehicle software to support alternative chips in 2-3 weeks. Volkswagen CEO Herbert Diess publicly called this "impressive." Traditional automakers had to wait for first-tier suppliers, who waited for chipmakers. Tesla called the chipmakers directly because it designs its own circuit boards.
The Tesla example is not "vertical integration is better than outsourcing." The lesson is more specific: every supplier relationship adds a coordination boundary. Each boundary becomes a wait state under pressure.
Tesla traded supplier cost for coordination control, and when market conditions shifted, the coordination control mattered more.
The key performance indicators that signal coordination, not development team output
Most product development teams track output. Engineering hours logged, milestones hit, drawings released, design change requests resolved. These measure activity inside the development phases.
A coordination-first product development strategy uses different key performance indicators (Exhibit 2). Five matter most:

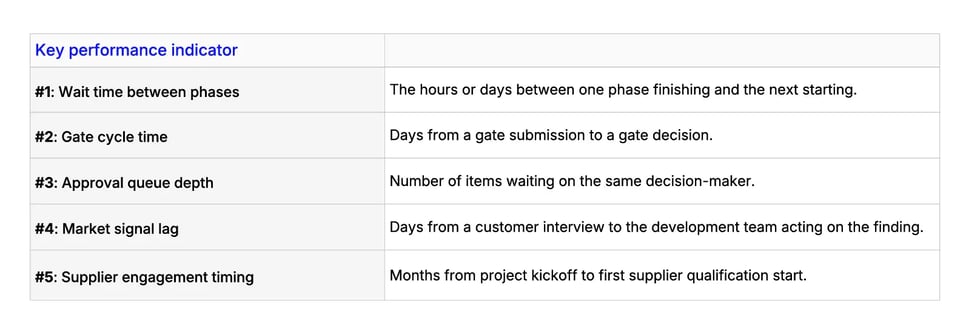

Exhibit 2: The five most important KPIs signaling coordination
Pair these with traditional KPIs on product quality, customer satisfaction at first customer shipment, and revenue goals against business goals. Coordination metrics catch the wait time. Output metrics catch the work. Both are needed.
How ITONICS helps industrial companies develop products and reach the market faster
A coordination-first product development strategy needs infrastructure that connects strategy, market signals, portfolio decisions, and execution in one place. Most companies run these in separate tools. Excel for portfolio. SharePoint for documents. Project management software for execution. Separate inboxes for market research. Meetings for approvals.
This patchwork is exactly what the Airbus A380 case demonstrates at scale. Different sites, different tools, no shared system of record. The development teams were not the problem. The coordination layer connecting them was.
ITONICS is designed for federated industrial organizations. It connects four flows that usually live in different systems:
- Strategy and market intelligence. Trends, signals, customer interviews, and competitive moves feed continuously into one source of truth. The development team gets fresh market data without waiting for a research phase to close (Exhibit 3).

Exhibit 3: Trends, signals, and customer interviews in one source of truth
- Portfolio and product strategy. Ideas, projects, and the existing product portfolio sit alongside the strategy that justifies them. Portfolio decisions get made on live data, on a cadence matched to development cycles.
- Execution and development phases. Development teams, key stakeholders, and the approval process work in the same system. Gate criteria, evidence, and decisions are visible to everyone before the review meeting.
- Reporting and key performance indicators. Board-grade reporting on time-to-market, wait states, and pipeline health is generated from live data. No slides are built from scratch every quarter (Exhibit 4).
/Still%20images/Reports%20Mockups%202025/portfolio-optimize-portfolio-returns-2025.webp?width=2160&height=1350&name=portfolio-optimize-portfolio-returns-2025.webp)
Exhibit 4: Time-to-market, wait states, and pipeline health generated from live data
For industrial companies running 18-30 coordination points across the entire process, ITONICS replaces the patchwork with a single platform. Approval queues become workflows. Market research feeds the development phases directly. Portfolio decisions and development cycles synchronize.
ITONICS does not replace the development team's engineering tools. It replaces the coordination layer that sits between them. That is where the months of wait time live, and that is where the time-to-market gains come from.
FAQs on time-to-market strategy for industrial companies
How long does it take to redesign coordination for an industrial development process?
8-12 weeks for the first pass.
-
Weeks 1-3: map wait states across the entire process.
-
Weeks 4-6: redesign gate criteria and approval workflows.
-
Weeks 7-9: set up the market research feed and supplier engagement.
-
Weeks 10-12: deploy KPI tracking. The first cycle time gain typically appears within 6 months of the next product launch.
Does this approach work for regulated industries with mandatory approval phases?
Yes. Regulated approvals are not the bottleneck in most cases. The wait time around them is.
What if our development team resists changes to the approval process?
The framework does not change what the development team does. It changes what happens between phases. Most development teams welcome the change because their work stops sitting in gate queues.
Resistance usually comes from gate owners, not developers. Address it by giving them clearer decision rights and pre-circulated evidence, which makes their job easier.
How do we know if our problem is coordination or development speed?
Run a wait-state audit. Track total time on the last completed product launch from concept to first customer shipment. Subtract engineering-active hours.
If the gap is more than 35% of the total time, coordination is your problem. In most industrial settings, the gap is 45-60%.
Can small product development teams use this framework?
Yes, with simpler tools. The framework is about wait states, not headcount. A 5-person development team in a 50-person industrial firm has fewer gates but often more decision-maker contention.
The pre-positioning principles apply directly. Skip formal stage gates and run the same coordination discipline informally with shared documents and standing slots.
How does this differ from agile or lean product development?
Agile and lean optimize the development team's work. This framework optimizes everything around the development team. They are complementary, not competing.
Agile teams still wait for gate approvals, market research, supplier qualifications, and portfolio decisions. Coordination-first design removes those waits, so agile cycles deliver to the market faster.
