Project portfolio management: 13 best practices for 2027

Project portfolio management best practices come down to one discipline: decide on evidence, at a fixed rhythm, and move money fast. The 13 practices below cover four stages: select, fund, review, and stop. Teams that review priorities often cancel more projects and report higher returns. Stopping is the skill most portfolios lack.
Most project portfolio managers measure success by delivery. Projects ship on time, on budget, and the dashboard turns green. That view misses the bigger cost. The money sits in projects that should have ended two quarters ago.
The 2026 data points the same way. PMI's Pulse of the Profession 2026 reports that 31% of complex projects fail to achieve their full intended benefits. That rate is more than twice the rate for projects overall. Tempo's 2026 State of Strategic Portfolio Management surveyed 667 planning and PMO leaders. Respondents report that nearly one in three projects was cancelled or stopped early for misalignment or weak ROI.
| Stage | Best practice | The test question |
|---|---|---|
| Select | 1. Run one intake for every source | Does every request enter through the same door? |
| Select | 2. Score against strategy with fixed weights | Would two reviewers rank the same project the same way? |
| Select | 3. Balance horizons on purpose | Does the mix match the target split? |
| Fund | 4. Fund in tranches tied to gates | Does each gate release only the next tranche? |
| Fund | 5. Plan capacity before you approve scope | Do the named people have the hours? |
| Fund | 6. Map skills to the projects that need them | Can you find the expert in one search? |
| Review | 7. Review priorities monthly, budgets quarterly | When did the portfolio last change? |
| Review | 8. Replace status decks with a live dashboard | How many hours go into the next steering deck? |
| Review | 9. Report decisions over activity | Which decisions did the last review produce? |
| Stop | 10. Write kill criteria at approval | Is the stop condition on record? |
| Stop | 11. Give the gate board explicit decision rights | Who can stop a project, in writing? |
| Stop | 12. Reallocate freed budget within 30 days | Where did the last stopped budget go? |
| Stop | 13. Run a review on every stopped project | What did the last stop teach the team? |

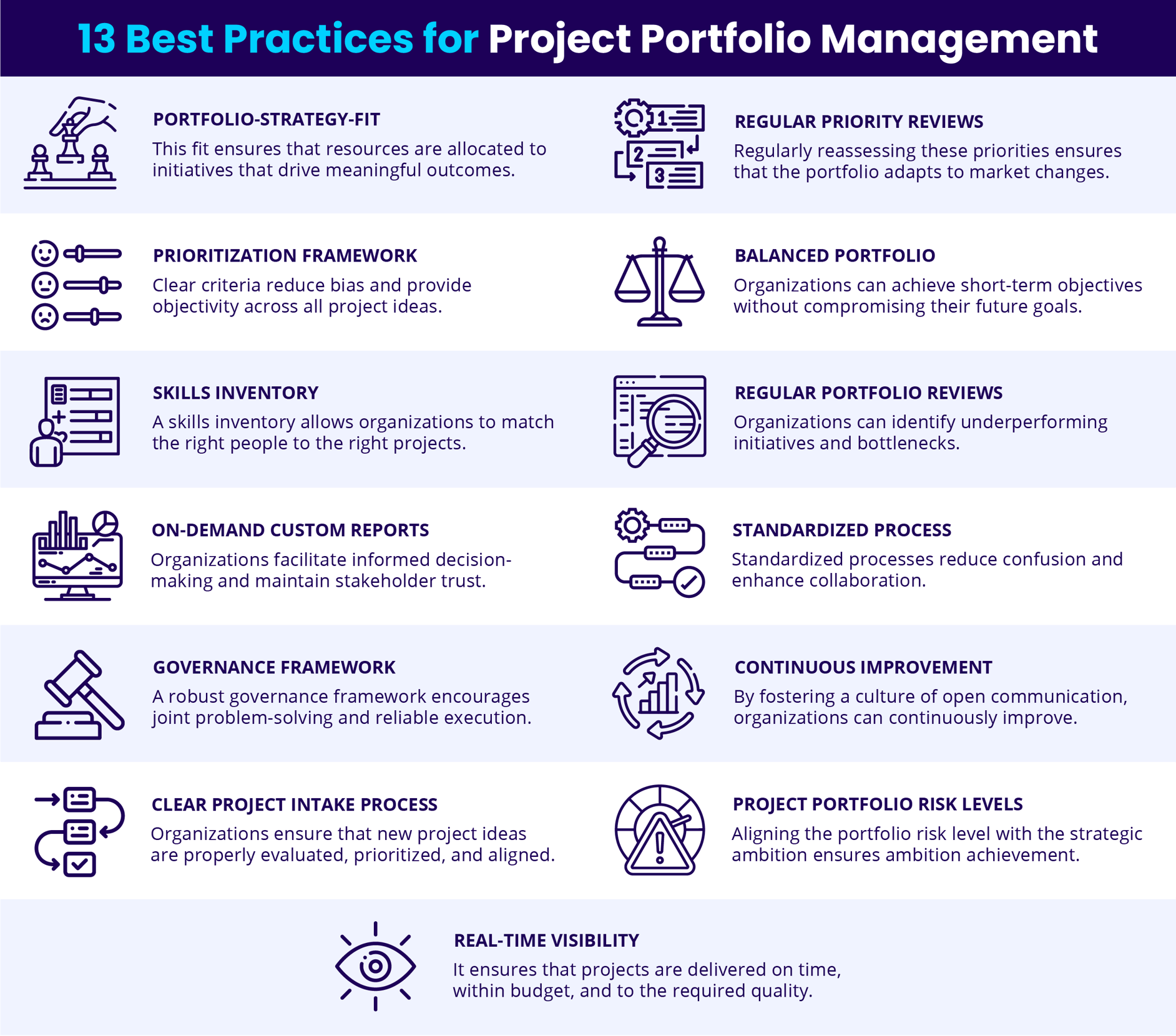

Exhibit 1: 13 project portfolio management best practices at a glance
Here is the twist. Teams that review priorities frequently cancel 8 percentage points more projects. They also report about 8 points higher ROI. Effective project portfolio management treats stopping as a feature of the system. Every stop frees money for the right projects.
This guide is written for portfolio managers in R&D, product, and innovation, and for the project management office (PMO) that supports them. It builds on our guides to strategic portfolio management and R&D portfolio management.
Every project portfolio management process runs the same loop. The project management office often runs the loop, close to program management. The portfolio management team owns the decisions. Teams track progress against business goals at every review. The 13 best practices sharpen each step.
Many organizations treat step five as a reporting exercise. Effective portfolio management turns it into a decision step. That shift explains most of the practices below. The loop exists to achieve strategic objectives with a limited budget.
A project portfolio improves when weak projects leave it early. Every approval creates a claim on people and budget. Without regular stops, those claims pile up until strong new projects wait in line.
Project portfolio management (PPM) is the centralized management of all the projects a company funds against its strategic objectives. Project management delivers individual projects through project management processes such as planning and scheduling. Program management coordinates related projects toward one outcome. Portfolio management decides which projects deserve the people and the budget. Successful project portfolio management needs all three, with clear handoffs.
Tempo's survey separates high performers from traditional planners. High performers report ROI or strategic value on 81% of projects. Traditional planning organizations report 45%. The gap tracks review frequency, integrated processes, and scenario planning.
Scenario planning users report ROI or strategic value on 17 percentage points more projects. PMI finds the same lever underused. About one in five practitioners use scenario planning today.
Both studies rely on self-reported data. The direction is consistent, though. Portfolios that look often and decide often keep fewer zombies.
Exhibit 2: Frequent reviewers stop more projects and earn more
Run three checks before changing any process.
First, count active projects per full-time equivalent in R&D. A ratio above one signals that people are managing multiple projects at once, and each one slows down.
Second, list projects older than their planned end date. Each one holds people a new project needs.
Third, ask finance how much budget moved between projects in the last twelve months. A number close to zero means the annual plan runs the portfolio, and strategy follows it.
Any of the three justifies changes to the project portfolio management process. All three call for a reset.
Selection locks in most of the project portfolio's future cost. A project that enters on a weak case consumes reviews, people, and patience before anyone stops it. Tight project selection protects every later stage.
Ideas, customer requests, technology scouting finds, and executive asks all compete for the same budget. Give them one intake form with the same minimum fields. Require a problem statement, an owner, a first cost estimate, and the business objectives it serves. Project managers and portfolio managers then work from the same project data.
One intake also exposes duplicates. Goldbeck saw this firsthand. Many departments scouted startups and ran pilots through parallel channels. People spent significant time working out who had talked to whom. A single view of all initiatives ended the duplicate work.
Weighted scoring turns debate into comparison. It is the fastest way to prioritize projects on strategic alignment over sponsor seniority. Pick five to seven criteria, such as strategic fit, business value, urgency, risk, feasibility, and time to impact. Fix the weights for the year and publish them.
Fixed weights keep reviewers honest. A project sponsor can argue a score. Changing the weights for one project requires the whole board. Fixed weights also align projects with business goals across business units. For a deeper criteria set, use our guide to project prioritization.
Scoring alone favors safe, near-term projects. They score high on feasibility and low on risk. Left alone, the portfolio drifts toward incremental work and low value projects.
Set a target split across horizons before scoring starts. The 70-20-10 model is a common starting point: core, adjacent, and transformational. Score projects within each horizon, then fill each bucket from the top.
Review the split once a year against business strategy and organizational goals. A company entering a new market may shift budget toward adjacent bets for two cycles. Document the change so the board scores against the new target.

Exhibit 3: Initiatives by phase and strategic objective on an ITONICS board
Funding in one annual block locks money into last year's assumptions. Tempo's respondents name capacity as the top barrier to executing strategy, cited by 30%. Funding and capacity planning belong in the same decision.
Resource allocation decides which strategic priorities get done. Allocate resources to the highest value projects first. Fund the rest only when resource capacity remains. Optimizing resource allocation starts with an honest count of ongoing projects.
Release budget per stage, sized to the next learning milestone. A concept phase gets enough to test the core assumption. A pilot phase gets enough to prove the business case.
Tranche funding caps the cost of a wrong bet. It also respects resource constraints, because each tranche names the people it needs. It also gives every gate a real decision, because money moves only when the evidence does. The stage-gate process supplies the structure.
Exhibit 4: Phases and gates with gate configuration in the ITONICS Workflow builder
A project approved without people becomes a project delayed by people. Capacity is a resource management question first. Before approval, name the critical roles and check their load for the next two quarters.
Use scenario planning here. Model the portfolio with and without the new project. Compare which existing projects slip. Leadership then decides with the trade-off in view. Resource managers and portfolio managers share one view of resource utilization, so resource constraints surface before project execution starts. Good resource management treats expert hours as the scarcest input in project work.
R&D portfolios depend on scarce experts. A battery chemist or a regulatory specialist often limits multiple projects at once, sometimes ten. Keep a skills map linked to project records.
When a new project arrives, search the map first. Assign the expert to the highest-scoring project and log the conflict for the rest.
The conflict log is portfolio data in its own right. Here the portfolio manager works closely with resource managers to balance workloads across multiple projects. A skill that blocks five projects every quarter points to a hiring or partnering decision. Bring that pattern to the annual planning round with numbers attached. Our article on R&D resource management covers allocation methods in detail.
A portfolio review earns its slot when it changes something. Track the share of reviews that end with a stop, a scale, or a reallocation. Reviews that only confirm status belong in a dashboard.
Regular portfolio reviews keep the portfolio aligned with business strategy as strategic goals shift. They are also where portfolio managers see the entire portfolio at once.
Priorities shift faster than budgets. A monthly priority review catches projects whose context changed. A competitor launched first, a regulation moved, or a technology matured early. Each review checks every project against current strategic goals.
Budget changes follow at the quarterly review. This cadence lets the portfolio react within weeks. Portfolio management turns dynamic, while governance stays stable. It also keeps finance on a predictable rhythm. Quarterly reviews allocate resources between portfolio projects.
Project status decks cost hours and age by the meeting date. Most project portfolio management tools ship a dashboard for this. Build one portfolio dashboard in your project portfolio management software. Show phase, health, budget burn, and the next gate date. Project status and project performance come from records that project teams already update.
The board then spends meeting time on exceptions and makes data driven decisions. Every attendee sees the same numbers before the meeting starts.
Start with four widgets and resist adding more. Portfolio value by horizon, projects by phase, projects past their gate date, and budget burn against plan. Each widget should answer a question the board asks every month.

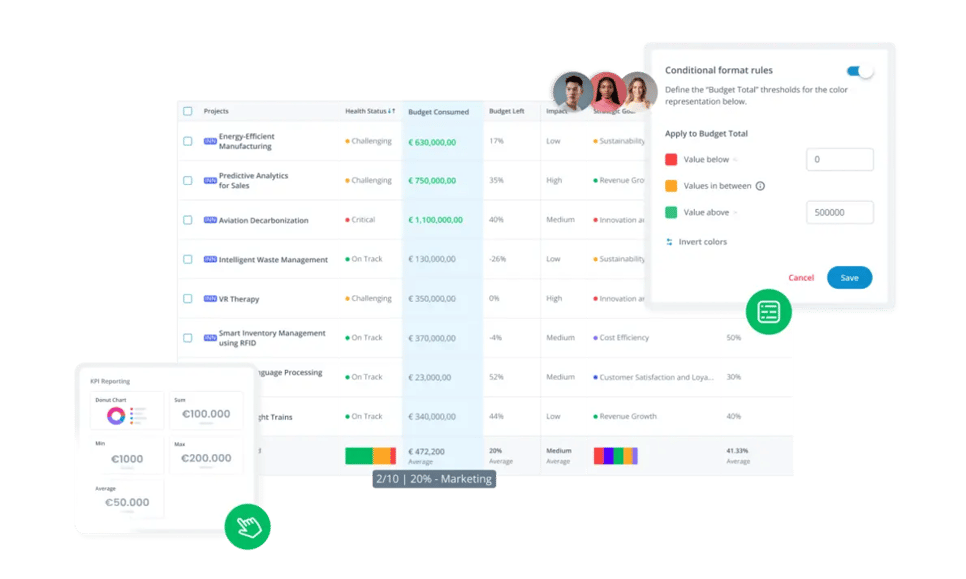

Exhibit 5: Portfolio dashboard with pipeline by horizon and forecast value inside ITONICS
End every review with a decision log. Record each stop, scale, start, and reallocation with its reason. Share the log with project teams and stakeholders within a day.
The log becomes the project portfolio's memory. New board members read it to learn how the board thinks. Project management teams read it to learn what evidence moves a decision.
Governance decides whether stops happen. Most portfolios have the data to stop projects. They lack a rule that forces the decision and a person who owns it.
Portfolio governance also covers portfolio risk. Assess risk for individual projects and for the entire portfolio. Identify potential threats early, such as a single key supplier, a single expert, or a pending regulation. Ten projects that depend on one technology or one customer form a single bet.
Set the stop conditions when the project starts, while the team is still neutral. Examples include a cost ceiling, a target customer test result, or a technology readiness level by a date.
At each gate, the board checks the criteria first. A project that misses them carries the burden of proof. Kill criteria protect strategic alignment long after approval. McKinsey goes one step further in its bias busters series. It recommends a dedicated reviewer who makes the case to stop each active project.
Write down who can stop a project, scale it, or move its budget. Name the board members and the quorum. Clear rights create accountability among stakeholders. PMI lists unclear governance as an organizational source of project complexity.
Explicit rights also protect project managers. A project manager who flags a weak result early faces the board, and the board owns the call. Our guide to innovation governance shows how to assign roles with RACI.
A stop only creates value when the money moves. Freed budget that waits for the next annual cycle disappears into general spend. Tempo uses the term strategic drift for funding that stays locked while priorities move on. Fast reallocation restores strategic alignment.
Keep a ranked waiting list of approved but unfunded projects. When a project stops, the next one on the list starts within 30 days. Rank the list against strategic goals to align projects with the current strategy.
Exhibit 6: Project list with owners, costs, and status inside ITONICS
Stopped projects carry the cheapest lessons in the company. Run a 45-minute review within two weeks of each stop. Capture what the team learned, which assumption failed, and what the next team should reuse.
Store the findings with the project record, so teams managing projects in the same field reuse them. Link them to the trends and technologies involved. The next project in the same field starts from evidence.
Celebrate good stops in public. A team that ends a project early on clear evidence saved the company money. Name that outcome in the portfolio review and in the decision log. People repeat what leadership rewards.
Measure project portfolio management by decisions and business value, alongside delivery. The five key performance indicators below show whether the practices work. Track portfolio performance quarterly and show the trend on the dashboard.
| Metric | What it shows | Starting target |
|---|---|---|
| Share of projects stopped per year | Whether gates make real decisions | 20% to 30% of active projects |
| Days from stop to budget reallocation | Whether freed money moves | 30 days or fewer |
| Share of portfolio by horizon | Whether the mix matches strategy | Within five points of target split |
| Active projects per R&D FTE | Whether capacity matches approvals | Below one |
| Hours spent on steering material | Whether reporting is automated | Down 50% in year one |
Exhibit 7: Five KPIs for effective project portfolio management
The targets are starting points from practice. Adjust them to your industry cycle. A pharma discovery portfolio stops more projects than a consumer goods portfolio, by design. For more metric ideas, see our R&D KPI guide.
ITONICS is strategic portfolio intelligence for enterprise R&D and innovation. It keeps projects, ideas, trends, and technologies as linked elements in one system. Portfolio decisions happen where the evidence sits.
Exhibit 8: Prism portfolio review with stop, scale, and start recommendations
Project portfolio managers use it as project portfolio management software that connects strategic alignment with project execution.
Project portfolio management best practices cover four stages. Select projects through one intake with fixed scoring weights. Fund them in tranches tied to gates and check capacity first. Review priorities monthly with a live dashboard. Stop projects against kill criteria written at approval, and move freed budget within 30 days.
Review priorities monthly and budgets quarterly. Monthly reviews catch projects whose context changed. Quarterly reviews move money on a predictable rhythm for finance. Tempo's 2026 survey links frequent priority reviews to more cancellations and about 8 points higher reported ROI.
Project management delivers one project on scope, time, and budget. Project portfolio management (PPM) decides which projects to start, fund, scale, or stop. It balances the whole set against strategy and capacity. A project can succeed on delivery and still belong outside the portfolio.
Write stop conditions when you approve the project. Use a cost ceiling, a customer test result, or a readiness level by a date. At each gate, check those criteria first. A project that misses them needs new evidence to continue. Give one named board the right to make the call.
Project portfolio management software should connect projects to the strategy and signals behind them. ITONICS links projects, ideas, trends, and technologies as elements. Configurable workflows run phases and gates, and Prism flags what to stop, scale, or start. Goldbeck used a single view of all initiatives to end duplicate work across departments.
